Patty Parson's Build Daily Log

Date: Sept. 16

On Site:  Frank J. Fraser
             Site Supervisor

Volunteers: It was a rainy day.  Nan Got us going in the morning. Rob Abbott,  Peter Hemming , Tom Nevil. Willy made an appearance at about 10:30 and stayed till we cleaned up.

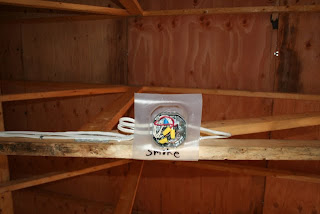

Contractors: A.D.A.D. The electricians returned again today to continue wiring 1014 which they tell me they are Done. Till we call them for hook up.


Visitors: Howard dropped by and seams to be recovering nicely. He also lent us another Hammer drill.

Daily Log: Weather WET all day. We received balance of dry wall. It was unloaded into the units. Started installing the  Tyvek from Dupont.  Finished  drilling  the holes for  Tap cons to hold the lower part of the concrete board with the drill Rob brought this morning.

Action / Follow up Items :
PS. Still no plumber. Spoke to their office on Wednesday still hoping the will  come on Saturday

Next Day / Week Plan: Build frame for knee wall in basements Finish Tyveking  exterior in preparation for windows and doors on Saturday. Then onto insulation and dry wall. Additional framing for the roof that was missed.  Check beam lamination,

Volunteer Requirements: lots of projects for Volunteers.

Materials / Tools : need Hammer drill and more drills for installation of framing for knee wall, concrete board, drills for drywall.

Inspections:Soon

Prepared By: Frank J. Fraser
